Primavera project planning

1st week course
- Contractual start and finish date
- Contract value. Payments terms and conditions.
- Collect scope of work
- BOQ or FOT( form of tender)
- Contractual milestones if any
- List of drawings
- Actual Execution Plan or Strategy
- Preliminary schedule ( level 1 or level 2 schedule if any)
- Organization chart company and contractor and contact numbers/emails
- Available manpower & equipment status
- Create Project:
- Project ID: PRJ-XYZ1
- Project Nam : Office building with HVAC & Fire Fighting
- Set Planned Start (As per contract )
- Set Planned finish (As per contract )
- Create Calendar:
- Create customized calender for Engineer, Procurement and Construction
- Create any customized calendars as required ( commissioning, etc)
- Mark public holidays during project duration ( say for 2 years)
- Create WBS
- Better to create WBS as per format of (BOQ / Form of tender)
- Project milestones, General, Engineering, Procurement, Construction, pre-commissioning & commissioning and Handover.
- Under construction
- Civil works
- Sub Structure
- Super Structure
- Mechanical works
- Electrical & Instrumentation works
- Civil works
- Create Activities
- Then give duration ( Note: duration based on quantity of work)
- Set all activities duration type as physical
- Give logical relationship and as per actual execution plan
- Give mandatory constraint if any only ( Better to avoid constraint in normal practice)
2nd week Course
- Adjust LAGS then DURATIONS in order to match contractual start and finish date.
- Copy and paste activities in excel file
- Calculate activity cost from BOQ ( for this )
- Break down BOQ cost to WBS level
- Then WBS level to Activity level ( recommended to assign cost only to those which are mentioned in BOQ)
- Finally/eventually break down cost match with BOQ total cost
3rd week Course
- Assign activity cost in primavera schedule by creating dummy resource ( note: for dummy resource remove tick from “auto complete actual” from resource-detail tab)
- First assign trapezoidal cure then enter activity cost
- ENSURE TOTAL SUMMRY COST MATCH WITH CONTRACT COST.
4th week Course

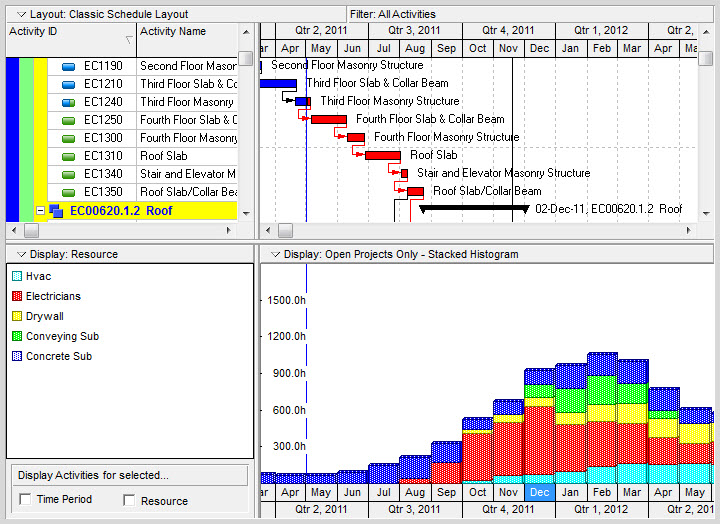

- WHICH COMPLETES PROJECT BASE LINE SCHEDULE ( LEVEL 2 – LEVEL-3- LEVEL-4 )
- LEVEL4 DETAIL SCHDLE. ( note : Plz ensure all BOQ items should cover in schedule)
- Float should not more than 10% of project duration
- There should not be open ends.
- We have to use minimum lag
